Sulphide Dev Hero

Underground Development

Defining a large underground resource

  • Measured and indicated: 3.95Moz Au, 4.16Moz AuEq​
    • 50.1Mt at 2.45 g/t Au and 2.58 g/t AuEq​​
  • Inferred: 0.40Moz Au, 0.42Moz AuEq​
    • 5.6Mt at 2.21 g/t Au and 2.33 g/t AuEq

The Camino Rojo deposit comprises three continuous zones with distinct characteristics:

  1. The Camino Rojo Oxide Deposit (“Camino Rojo Oxides”), hosted by the Caracol formation,
  2. The Camino Rojo Sulphide Deposit, the sulphide continuation of the Camino Rojo Oxides, also hosted by the Caracol formation (“Camino Rojo Sulphides” or “Sulphides”); and

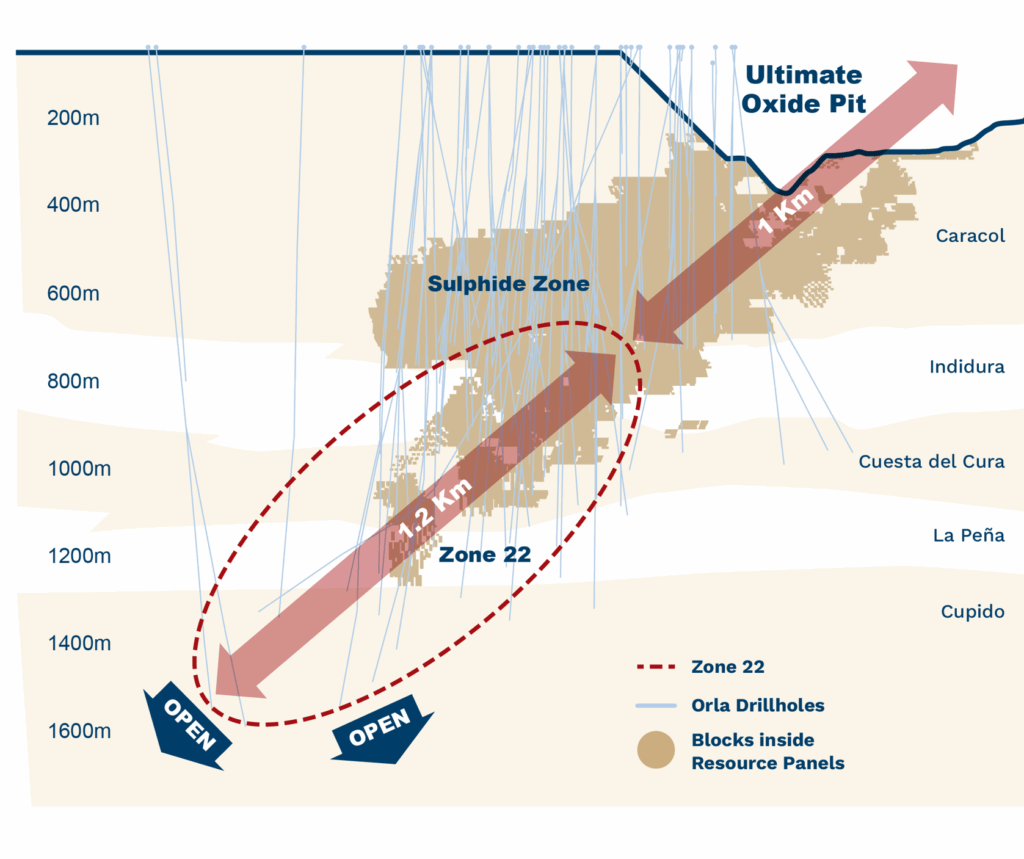

  3. Zone 22, an extension of the Sulphides, hosted by the limestone-rich Indidura, Cuesta del Cura, La Peña, and Cupido formations.

Evolution of Camino Rojo Deposit:

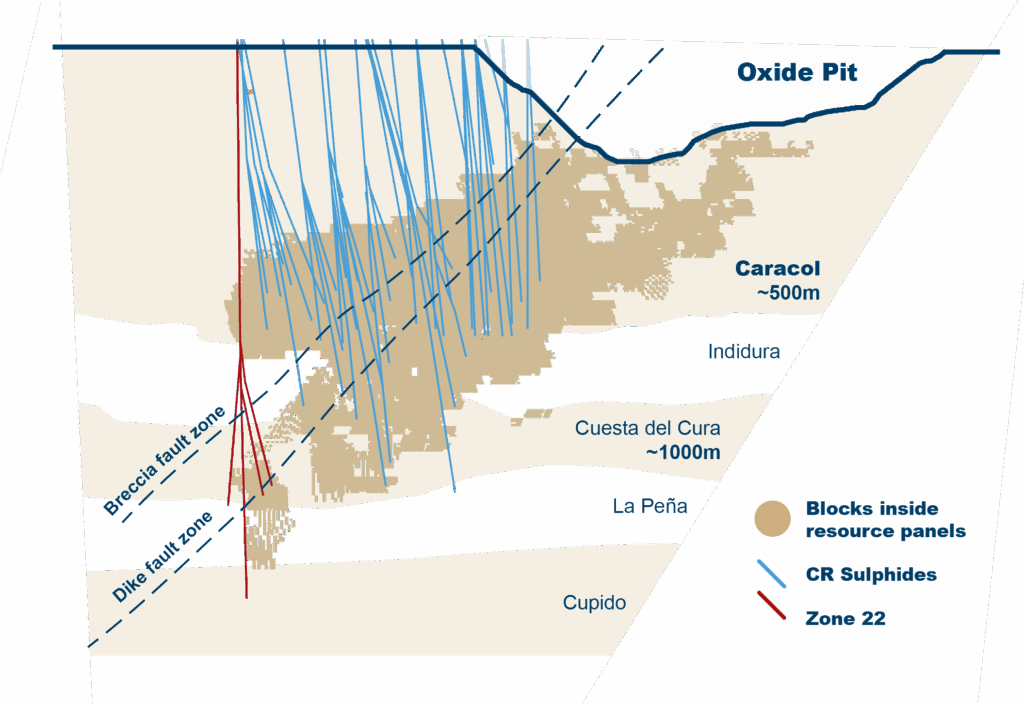

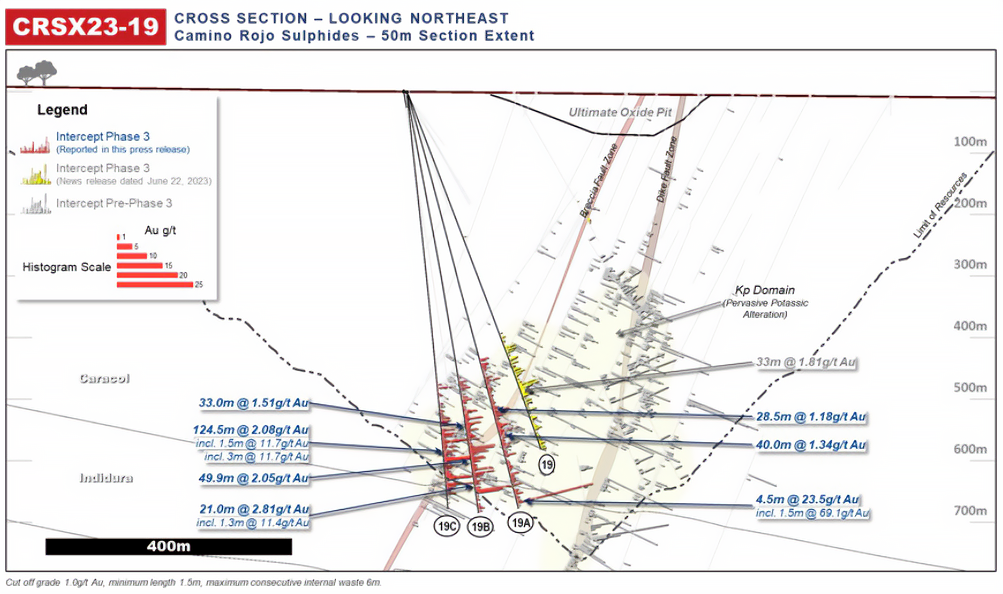

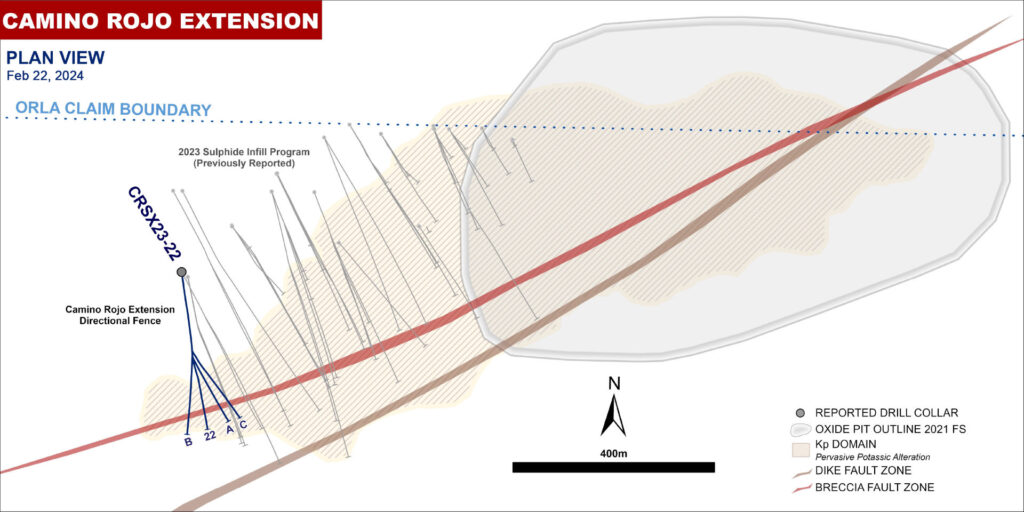

Orla’s north-to-south drilling programs, spanning from 2020 to 2024, along with historical drilling, have been instrumental in enhancing the geological model. This work has significantly improved the understanding of the distribution and geometry of sulphide-bearing veins hosted within the Caracol Formation, which is the main host for both the Camino Rojo Oxides and Camino Rojo Sulphides

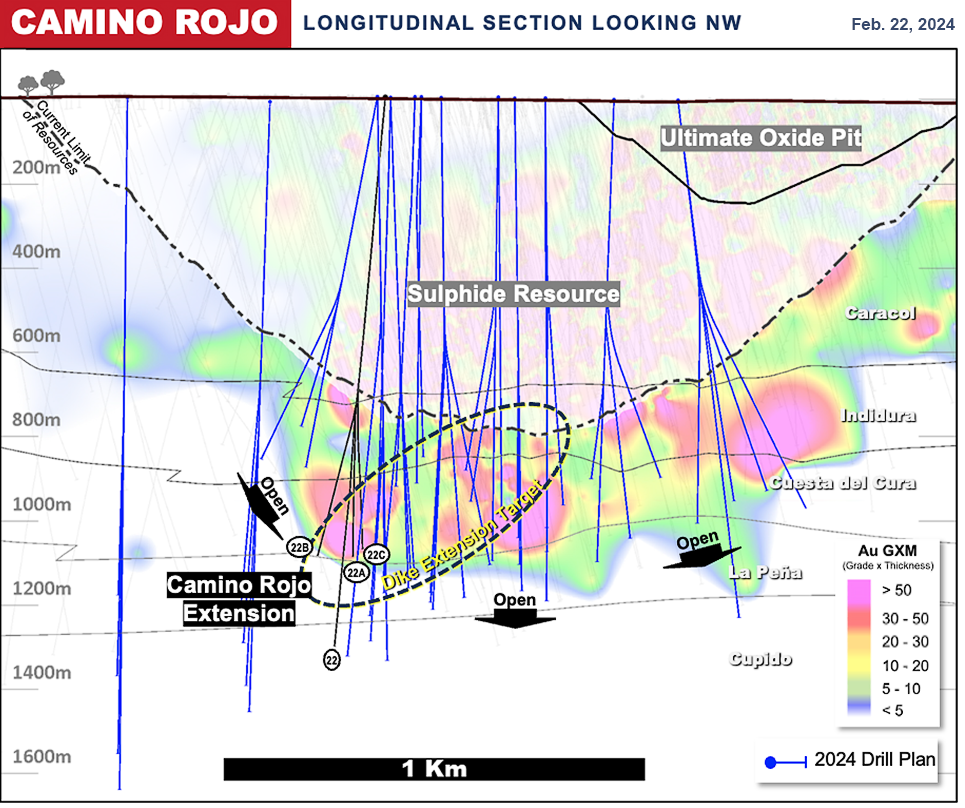

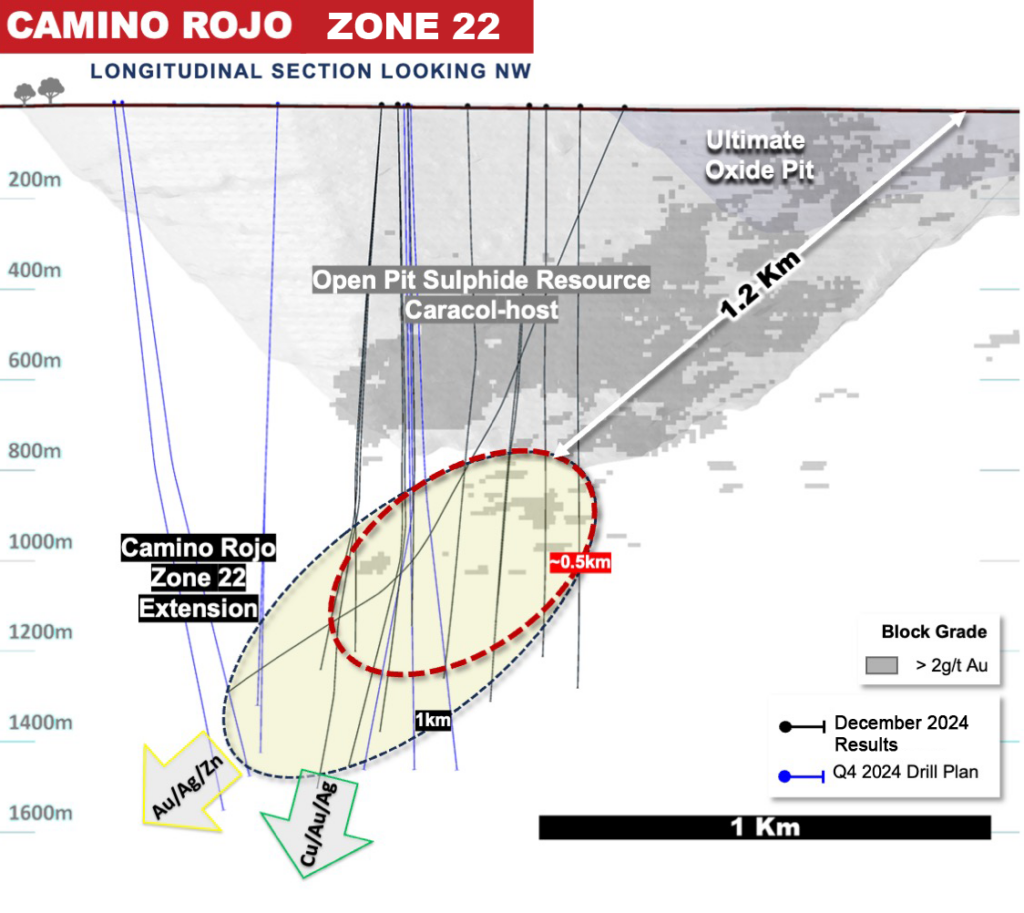

Zone 22, an extension of the Sulphides, had been intersected in historical drilling but lacked a supporting geological model to define its geometry or extension into the deeper carbonate-rich formations below the Caracol Formation. Orla’s updated model enabled strategic drilling along a section drilled in 2023, targeting the deposit’s down-plunge extension. This drilling confirmed the model and supported further drilling in 2024 to define and expand Zone 22.

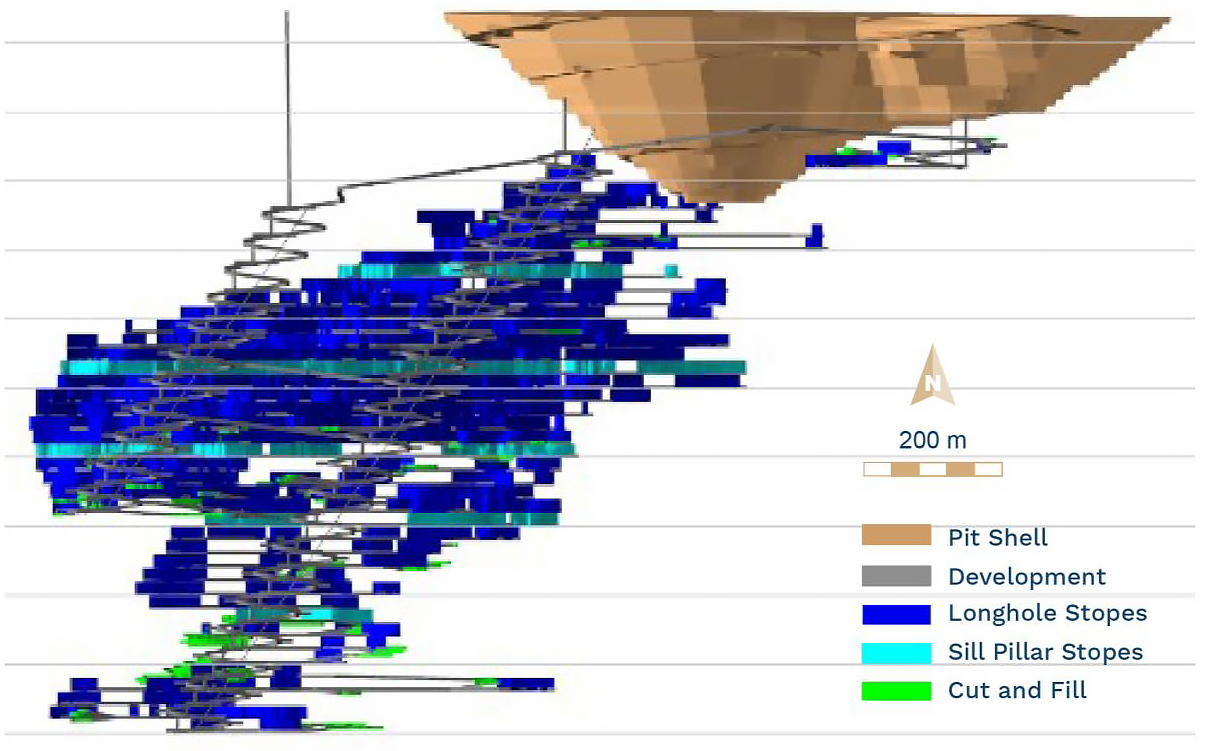

Initially, the development plan for the sulphide portion of the Camino Rojo deposit was conceived as a large open pit. However, initial estimates by previous operators, and later by Orla, indicated that such a scenario would require significant waste stripping, expanding the pit onto a third-party property, and constructing a substantial processing facility. An underground development scenario provides a more focused, high-value alternative by targeting higher-grade, metallurgically favourable parts of the deposit (those suitable for direct cyanide leaching) as an initial phase of mining. Subsequent phases would address mineralization requiring pre-treatment, such as pressure oxidation, prior to cyanidation.

Additionally, underground development could operate in parallel with the ongoing oxide pit. The upcoming PEA (expected in 2026) is expected to evaluate the underground resource as an expansion of the current operation, enabling Orla to maximize the project’s full potential.

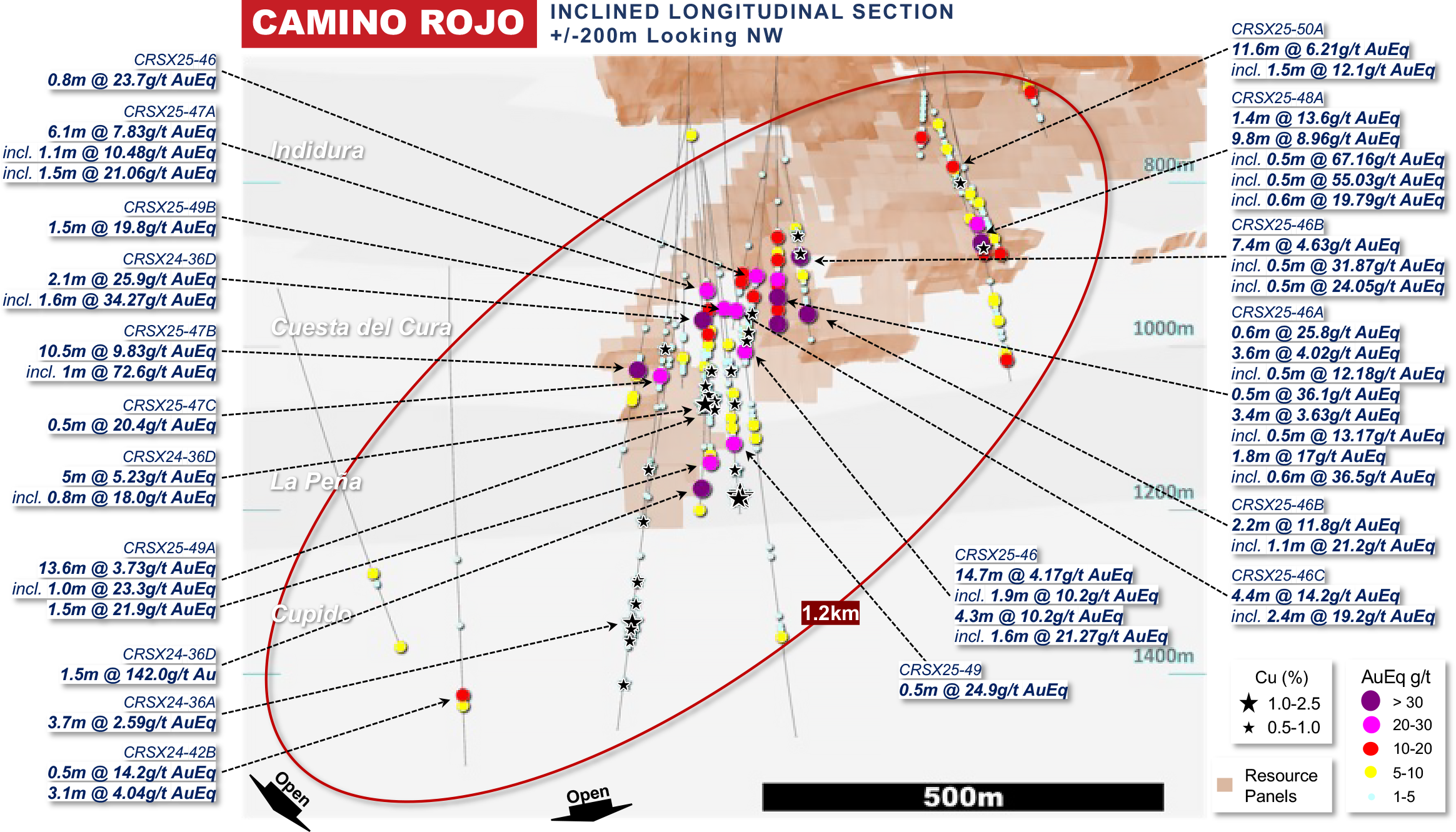

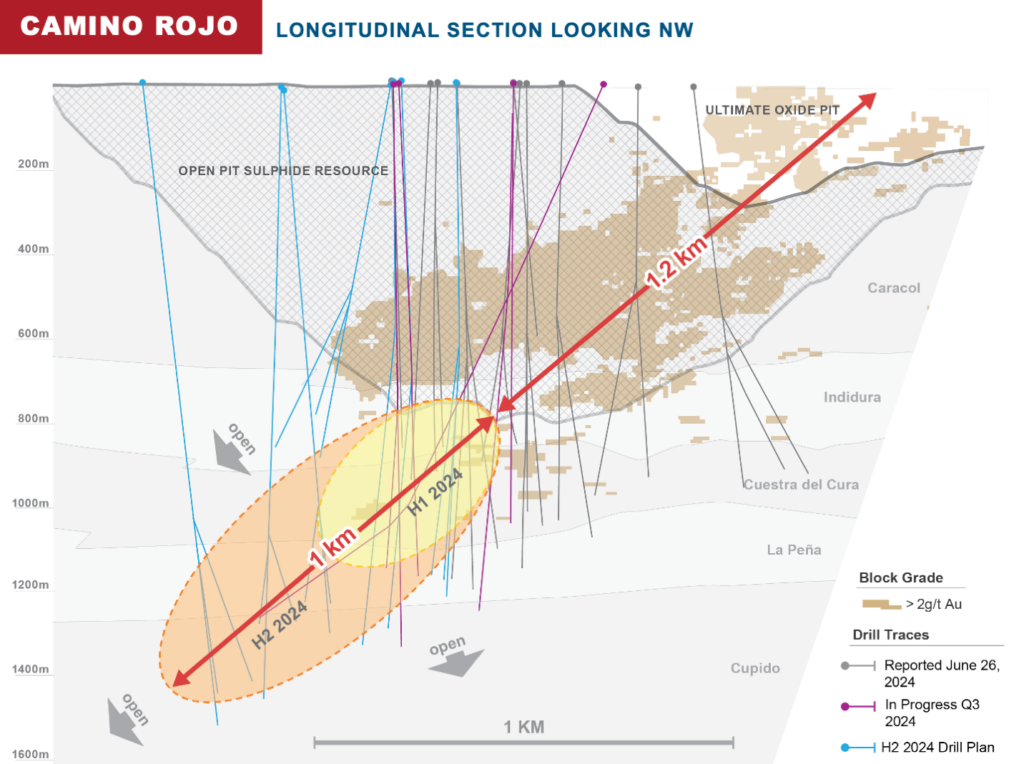

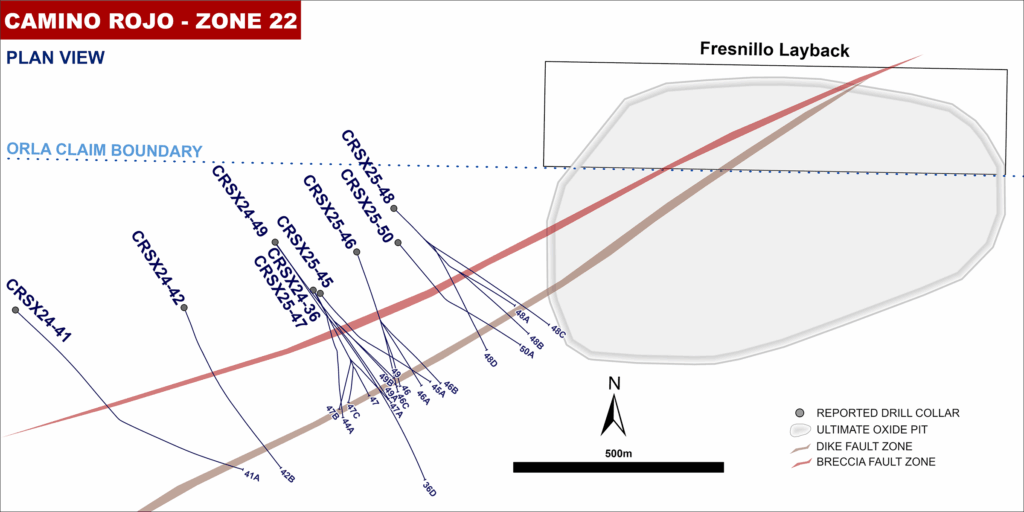

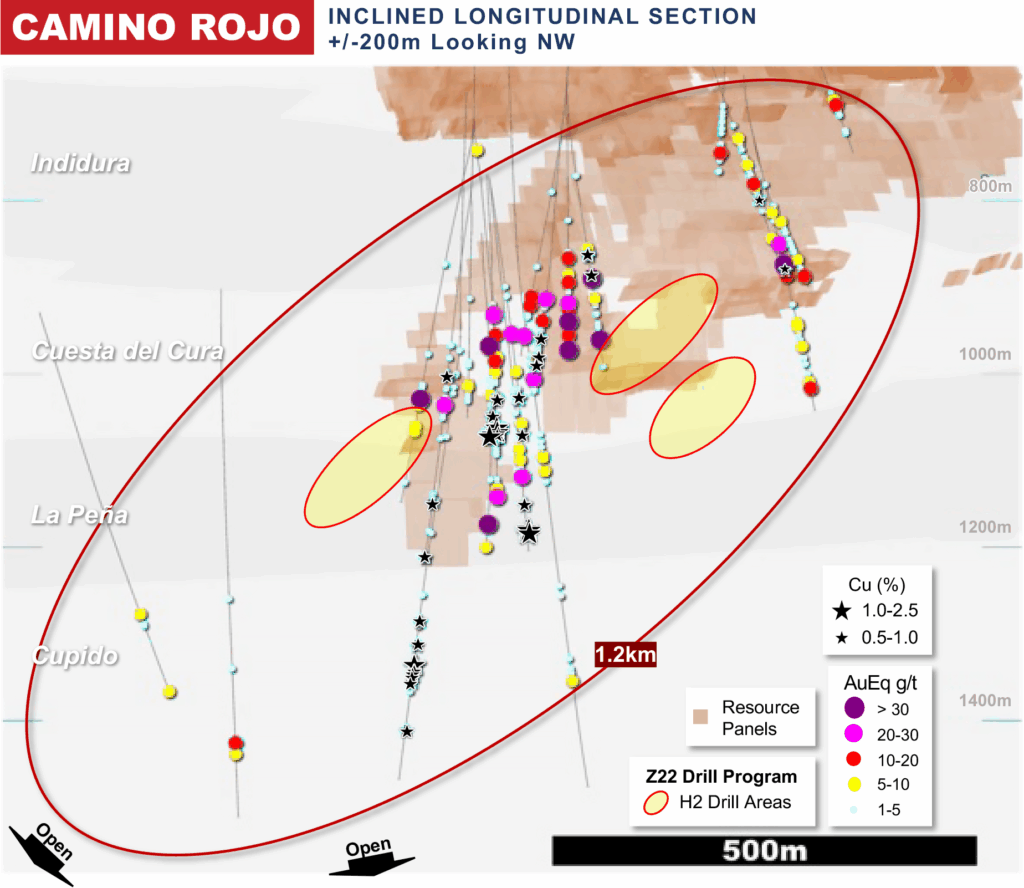

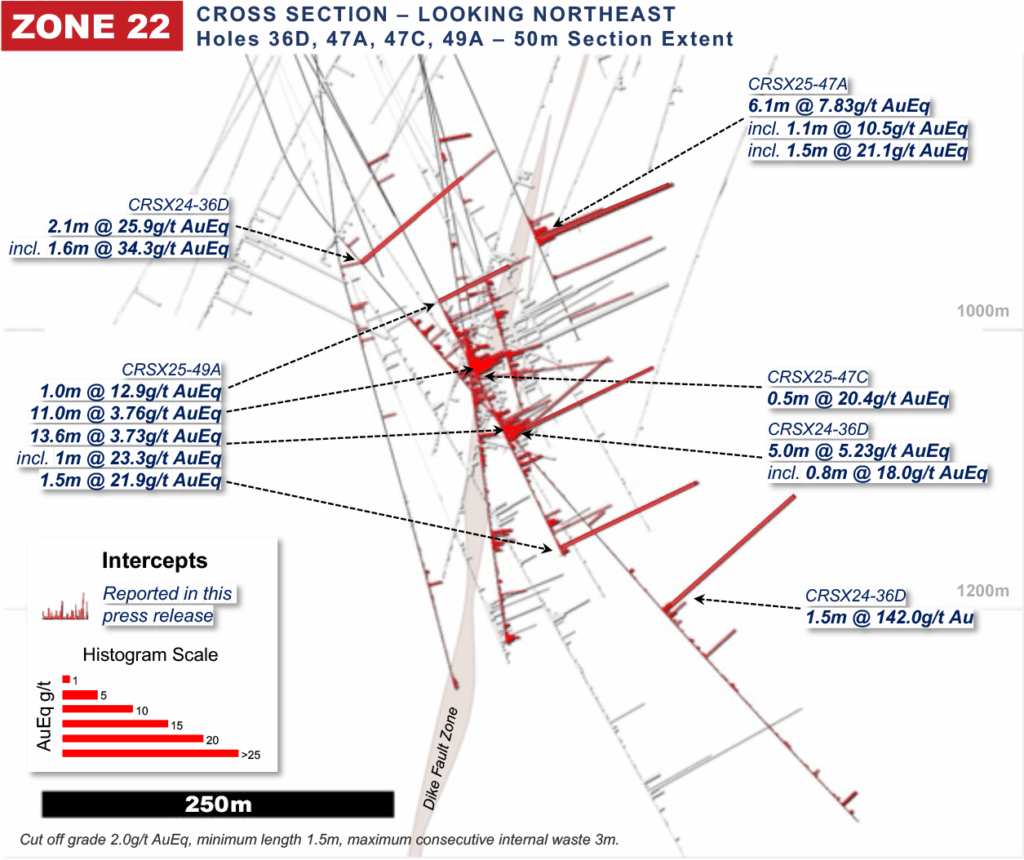

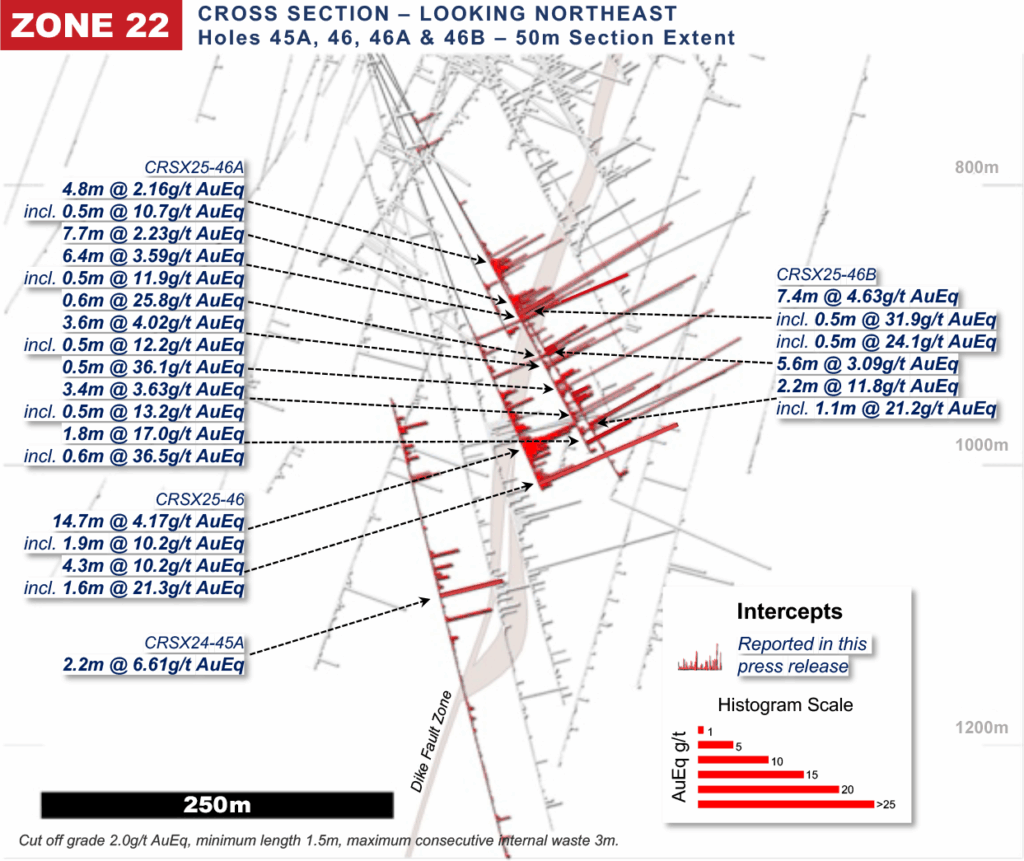

Orla is currently advancing a 20,000m drill program aimed at upgrading and expanding the Zone 22 resource, with 15,000 m drilled to date. Visual drill intercepts and assays continue to support the geological model and continuity of mineralization (Please see press release dated August 7, 2025). This program is expected to be completed by year end and is anticipated to extend and infill the down-plunge extension.

The gold equivalent (AuEq) for heap leach material is calculated with the following formula: Au grade (g/t) + (US$0.84 x Ag recovery x Ag grade (g/t)) /(US$71.98 x Au recovery). The AuEq for CIL material is calculated with the following formula: Au grade (g/t) + (US$0.73 x Ag recovery x Ag grade (g/t)) / (US$68.34 x Au recovery). The AuEq for CIL w/POX material is calculated with the following formula: Au grade (g/t) + (US$0.73 x Ag recovery x Ag grade (g/t)) / (US$68.34 x Au recovery) + (US$0.00146 x Zn recovery x Zn grade (ppm)) / (US$68.34 x Au recovery).

Drill Results Tables

Future Plans

The next phase of exploration to support the possible development of the underground deposit (including Zone 22) includes the planning of an underground exploration drift (decline).  The exploration drift would allow access for closer-spaced drilling aimed at further resource definition and support technical studies to continue advancing toward a Mineral Reserve estimate. Permitting and early development planning [SS3] are underway, with construction of an exploration drift possibly starting as early as 2026.

Engineering and metallurgical studies are ongoing and will expand to deliver a Preliminary Economic Assessment (PEA) in 2026, providing a conceptual operating plan and highlight the potential value of developing underground operations.

Orla expects to continue with metallurgical testing and other technical work to support feasibility-level evaluations and final permitting for both underground operations and associated surface infrastructure. The conceptual development plan is designed to enable a smooth transition from open pit to underground mining at Camino Rojo.

Underground Mineral Resource Estimate

MeasuredIndicatedMeasured & Indicated
Gold (Au)ktg/tkozktg/tkozktg/tkoz
Heap leach71.9501,7042.91591,7112.9159
CIL12,4752.0783212,4752.07832
FLOT/POX/CIL35,9002.562,95835,9002.562,958
Total – Gold71.95050,0792.453,94950,0862.453,950
Silver (Ag)ktg/tkozktg/tkozktg/tkoz
Heap leach731.571,70413.27221,71113.3729
CIL12,4758.73,48012,4758.73,480
FLOT/POX/CIL35,90011.112,84735,90011.112,847
Total – Silver731.5750,07910.617,04850,08610.617,055
Zinc (Zn)kt%Mlbkt%Mlbkt%Mlb
Heap leach
  CIL
  FLOT/POX/CIL35,9000.3527835,9000.35278
 Total – Zinc00035,9000.3527835,9000.35278
AUEQ (Au)ktg/tkozktg/tkozktg/tkoz
Heap leach72.1111,7043.031661,7113.03166
CIL12,4752.1184812,4752.11848
FLOT/POX/CIL35,9002.723,14235,9002.723,142
 Total – AUEQ72.11150,0792.584,15650,0862.584,156
Totalsktg/tkoz/Mlbktg/t or %koz/Mlbktg/t or %koz/Mlb
Au71.95050,0792.453,94950,0862.453,950
  Ag31.5710.617,04810.617,055
  Zn0.252780.25278
AuEq2.1112.584,1562.584,156
 Inferred
Gold (Au)ktg/tkoz
Heap leach2142.2916
CIL2,5491.81148
FLOT/POS/CIL2,8132.57232
Total Au5,5762.21396

Silverktg/tkoz
Heap leach21415.1104
CIL2,54910.2835
FLOT/POS/CIL2,81311.21,010
Total Au5,57610.91,949

Zinckt%Mlb
Heap leach
CIL
FLOT/POS/CIL2,8130.4226
Total Zn2,8130.4226

AuEqktg/tkoz
Heap leach2142.4417
CIL2,5491.85152
FLOT/POS/CIL2,8132.75249
Total Zn5,5762.33418

Totalsktg/t or %koz/Mlb
Au5,5762.21396
Ag10.91,949
Zn0.2126
AuEq2.33418

Mineral Resources Notes:

  1. CIM (2014) definitions were followed for Mineral Resources. The mineral resource estimate for Camino Rojo has an effective date of March 31, 2025.
  2. The Qualified Person responsible for the mineral resource estimate is Marie-Christine Gosselin, P.Geo., Senior Resource Geologist of SLR Consulting (Canada) Ltd.
  3. Mineral resources are estimated using a long-term price of US$2,300 /oz gold, US$1.25 /lb zinc and US$29 /oz silver and the following smelter terms: for oxide 99.9% payable Au and 98% payable Ag, and for sulphide 95% payable Au, 90% payable Ag and 95% payable Zn. Offsite costs (refining, transport and insurance) of US$145 /wmt transportation and US$230 /dmt treatment; a 2.5% NSR royalty.
  4. Metallurgical recoveries vary according to geometallurgical domains from heap leach and flotation (CIL, CIL with POX) and are either constant or formula based. Heap leach recoveries range from 40% to 70% for gold and from 11% to 34% for silver. For CIL and CIL with POX, gold and silver recoveries are calculated using grade dependent formulae. The underground CIL mean recovery is 92% for gold and 36% for silver. The underground CIL with POX mean recovery is 85% for gold and 41% for silver. Zinc recovery by flotation is 80%.
  5. Mineral Resources are estimated in underground resource panels using NSR cut-off grades of 59.02 US$/t for leach material, 68.73 US$/t for CIL material, and 76.23 US$/t for CIL w/POX material. Underground resource panels have a minimum width of 2m.
  6. The NSR for heap leach material is calculated with the following formula: NSR ($/t) = US$71.98 x Au recovery x Au grade + US$0.84 x Ag recovery x Ag grade (g/t). The NSR for flotation CIL material is calculated with the following formula: NSR ($/t) = US$68.34 x Au recovery x Au grade (g/t) + US$0.73 x Ag recovery x Ag grade (g/t). The NSR for CIL w/POX material is calculated with the following formula: NSR ($/t) = US$68.34 x Au recovery x Au grade (g/t) + US$0.73 x Ag recovery x Ag grade (g/T) + US$0.00146 x Zn recovery x Zn grade (ppm).
  7. The gold equivalent (AuEq) for heap leach material is calculated with the following formula: Au grade (g/t) + (US$0.84 x Ag recovery x Ag grade (g/t)) /(US$71.98 x Au recovery). The AuEq for flotation CIL material is calculated with the following formula: Au grade (g/t) + (US$0.73 x Ag recovery x Ag grade (g/t)) / (US$68.34 x Au recovery). The AuEq for CIL w/POX material is calculated with the following formula: Au grade (g/t) + (US$0.73 x Ag recovery x Ag grade (g/t)) / (US$68.34 x Au recovery) + (US$0.00146 x Zn recovery x Zn grade (ppm)) / (US$68.34 x Au recovery).
  8. Numbers may not add due to rounding.

The Mineral Resource estimate includes Inferred Mineral Resources that are considered too speculative geologically to have economic considerations applied to them that would enable them to be categorized as mineral reserves. Mineral Resources that are not Mineral Reserves do not have demonstrated economic viability.

The following factors, among others, could affect the mineral resource estimate: commodity price and exchange rate assumptions, pit slope angles, assumptions used in generating the resource pit shell and underground resource panels, including metal recoveries, and mining and process cost assumptions.
